Continuous flight auger piles are cast-in-place piles formed by drilling with a hollow-stem auger and pumping concrete or grout through the stem as the auger is withdrawn. Reinforcement is then installed while the material remains workable, according to the project design.
Also known as CFA piling, the method avoids leaving the full pile bore open between drilling and concreting. It is used for building foundations, infrastructure and certain retaining structures where ground conditions and installation requirements suit the system.
Successful continuous flight auger pile construction depends on coordinated drilling, material delivery and auger withdrawal. The following guide explains the installation sequence, equipment functions, quality records and construction issues that contractors should review.

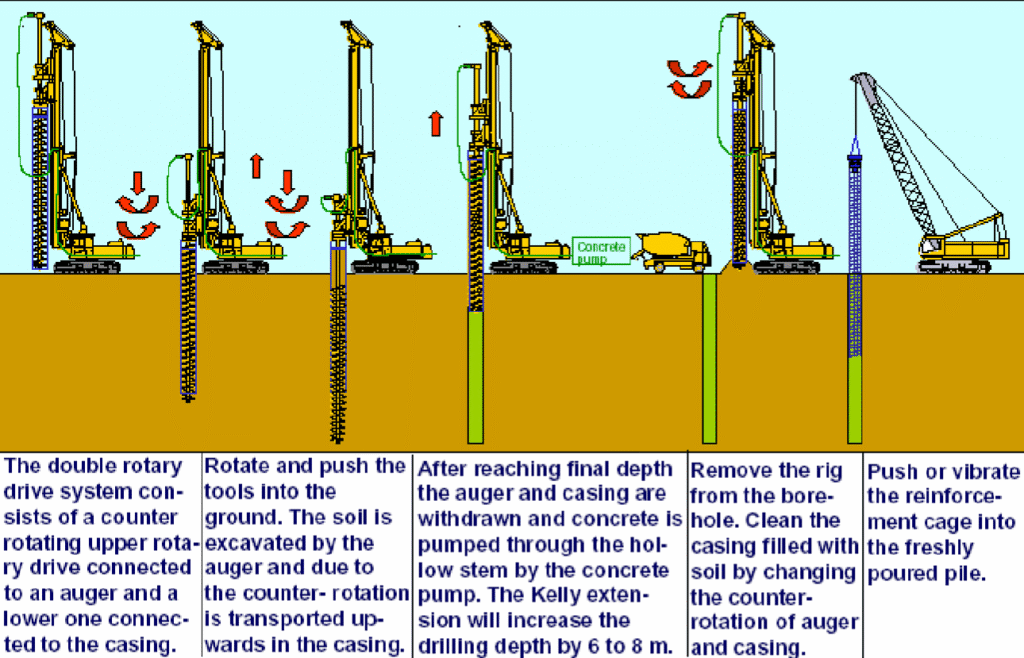

How Continuous Flight Auger Piles Are Constructed
A typical CFA installation progresses from site preparation through drilling, concreting, reinforcement placement and pile-head finishing. The detailed method and acceptance requirements should be established in the project’s approved installation plan.
1. Prepare the Site and Position the Rig
Confirm the pile layout, underground services, working platform and operating clearances before positioning the rig. The site arrangement must also accommodate concrete deliveries, pumping equipment, reinforcement handling and spoil removal.
Check the pile reference and rig alignment against the setting-out information. Confirm that the auger, connections, delivery system and monitoring equipment are ready before beginning the pile.
2. Drill to the Required Depth
The hollow-stem continuous flight auger advances into the ground while its flights convey excavated material upward. Drilling should follow the parameters established for the site rather than a single rotation speed applied to every soil layer.
Record depth, rotation, penetration rate and available torque or crowd-force data. Compare changes in drilling response and recovered spoil with the expected ground profile.
Excessive rotation relative to penetration can remove more surrounding soil than intended. This is commonly described as excessive flighting or soil mining and is a construction-control issue, particularly in susceptible ground.
3. Place Concrete or Grout During Auger Withdrawal
At the required depth, the approved tip-opening and pumping procedure establishes material delivery through the hollow stem. Concrete or grout then fills the space created as the auger is withdrawn.
Coordinate withdrawal with delivery so that the pile is formed continuously. Monitor material pressure, flow or volume, auger depth and extraction rate together. A total pump-volume reading alone does not show whether delivery was adequate throughout the pile length.
Any interruption should be documented and managed through the approved contingency procedure. The response depends on the stage of installation, material condition and site circumstances.
4. Install the Reinforcement
Prepare the pile top and install the specified reinforcement while the concrete or grout remains workable. Cage length, stiffness, lifting arrangement, centralizers and material workability all influence installation.
Record the actual reinforcement depth and any difficulties encountered. If the cage cannot reach its intended position, refer the issue for assessment rather than assuming that additional installation force is acceptable.
5. Finish the Pile Head and Complete the Records
Complete pile-top preparation and subsequent trimming in accordance with the project requirements and concrete condition. Record the relevant elevations and any removal of contaminated material.
Retain the installation log, material delivery and test records, reinforcement information and details of interruptions or unusual observations. These records support the project’s inspection and acceptance process.

Equipment Required for CFA Piling
The drilling rig, auger and delivery system must operate as a compatible installation system.
| Equipment | Main function | What to confirm before work |
|---|---|---|
| CFA-capable drilling rig | Rotates, advances and extracts the auger | Approved CFA configuration, working depth, torque, extraction capacity and clearances |
| Hollow-stem continuous flight auger | Cuts the ground and provides the material-delivery passage | Diameter, length, cutting arrangement, connections and stem condition |
| Pump and delivery system | Supplies concrete or grout through the stem | Mix compatibility, delivery capacity, line condition and suitable connections |
| Monitoring equipment | Records drilling and placement parameters | Required measurements, calibration and usable records |
| Reinforcement-handling equipment | Positions the cage or other specified reinforcement | Lifting arrangement, access, cage stability and installation requirements |
A rotary rig’s Kelly-drilling capacity does not automatically establish its CFA capability. Confirm the manufacturer-approved arrangement and the performance of the complete system.
Detailed tooth and flight selection is covered separately in Rockway’s guide to choosing a continuous flight auger for different ground conditions.
Quality Control During CFA Pile Installation
Much of CFA pile formation takes place below ground and cannot be inspected directly. Installation records therefore need to connect what the equipment was doing with the depth at which it occurred.
| Control area | Records to review | Purpose |
|---|---|---|
| Position and alignment | Pile reference, location and alignment checks | Confirm installation against the design layout |
| Drilling | Depth, rotation, penetration and available torque or crowd data | Identify changes in drilling response and possible excessive soil removal |
| Material placement | Delivery pressure, flow or volume, withdrawal rate and auger depth | Assess continuity of placement along the pile |
| Materials and reinforcement | Delivery times, specified material tests, cage details and installed depth | Confirm consistency and document installation |
| Completion | Pile-top condition, interruptions and specified verification tests | Support assessment and acceptance |
Automatic records should be reviewed alongside site observations. Instrument calibration, sensor location and the measurement system affect how the data should be interpreted. For example, pressure measured in a delivery line should not automatically be treated as the exact pressure at the auger outlet.
The FHWA guide to CFA pile design and construction provides a technical reference for installation monitoring and quality assurance. Project criteria should be established from the applicable specification and approved installation plan, with trial-pile results where required.
Check Material Volume Against the Pile Geometry
For a nominal cylindrical pile, the theoretical volume is:
V = π × D² × L ÷ 4
Where:
- D is pile diameter in metres.
- L is pile length in metres.
- V is volume in cubic metres.
For example, a 600 mm diameter pile with a 20 m length has a theoretical volume of approximately 5.65 m³.
This is a geometric reference, not a concrete order quantity or an acceptance threshold. Actual demand also depends on ground response, the placement method, pile-top requirements and material remaining in the delivery system.
Review consumption against depth and installation events. A higher total volume does not, by itself, prove that the pile is sound.
Common CFA Piling Problems and What to Review
The following observations identify topics for investigation; they do not establish a diagnosis without the installation records.
| Observation | Issues to investigate |
|---|---|
| Excessive spoil or ground movement | Rotation relative to penetration, ground conditions and evidence of soil mining |
| Irregular material pressure or delivery | Pump performance, delivery-line condition, material workability and withdrawal coordination |
| Unusually high or low material consumption | Measurement accuracy, depth records, ground response and placement interruptions |
| Reinforcement stops above the required depth | Elapsed time, workability, cage stiffness, alignment and installation arrangement |
| Slow drilling or rapid tooth wear | Unexpected hard layers, obstructions, tool condition and rig capability |
Record abnormal events with the pile reference and depth. Changes to the installation method should be reviewed by the responsible personnel and reflected in the subsequent work and records.
Ground Suitability and Comparison with Rotary Bored Piling
CFA piling can be considered for suitable cohesive and granular soils, including some water-bearing conditions. Its ability to combine drilling and concreting can support efficient production with relatively low vibration.
Suitability still depends on the full ground profile, pile dimensions, reinforcement requirements and nearby structures. Significant obstructions, large boulders, hard rock or soils susceptible to excessive flighting can limit conventional CFA installation.
CFA piles are themselves a form of bored cast-in-place pile. The useful comparison is with conventional rotary bored piling, where excavation and concrete placement are separate operations.
| Construction feature | CFA piling | Conventional rotary bored piling |
|---|---|---|
| Excavation | Hollow-stem continuous flight auger | Interchangeable augers, buckets or rock tools |
| Concrete placement | Through the stem during auger withdrawal | After excavation and bore preparation |
| Reinforcement | Normally installed into fresh material | Normally installed before concrete placement |
| Bore support | Depends on the CFA installation system and ground response | May involve casing, support fluid or stable open-hole conditions |
Neither method is universally preferable. Selection should follow the foundation design, investigation results and proposed construction system.

CFA Augers and Cutting Components for Your Project
Rockway supplies continuous flight augers for CFA pile construction, with configurations covering different diameters, lengths, connections and cutting arrangements.
For a configuration review and quotation, provide:
- The exact drilling rig model and its CFA configuration.
- Required pile diameter and installation depth.
- Ground investigation information, including hard layers and obstructions.
- Existing auger and connection drawings or clear photographs.
- Requirements for complete augers, sections or replacement cutting components.
- Quantity, delivery location and target delivery date.
These details help define the proposed supply and identify connection or application questions before ordering.
Frequently Asked Questions
The terms often describe closely related hollow-stem auger installation methods, although usage varies between markets and specifications.
There is no single maximum depth for every CFA system. Achievable depth depends on the rig configuration, auger arrangement, diameter, ground conditions, extraction capacity and reinforcement installation method. Confirm the proposed combination against the actual equipment documentation.
They can be suitable in some water-bearing formations. Feasibility depends on ground stability, drilling control and continuity of material placement. Groundwater conditions should be assessed as part of the installation plan.
Only where the rig has a suitable manufacturer-approved CFA configuration and compatible supporting systems. Changing the auger or cutting teeth alone does not establish that the machine can perform CFA installation.
No. Additional consumption may reflect ground response, placement conditions or measurement issues. Review the volume profile with pressure, depth, withdrawal records and the specified testing; assess acceptance against the project requirements.
